2014-03-03 Choose a project proposal and send the result via email to epsatisep@gmail.com

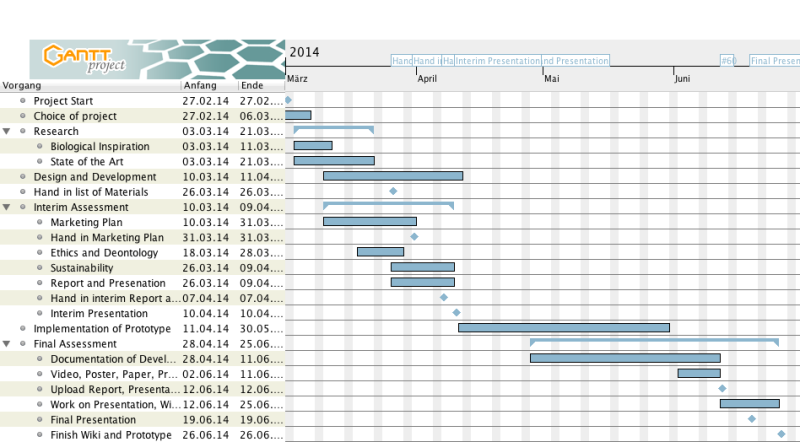

2014-03-10 Define the Tasks (what must be done), Task allocation (who does what) and Gantt chart (when) of the project and insert them on the wiki (planning)
2014-03-26 Specify the list of material (what, quantity, where to buy - local companies are mandatory) on the wiki
2014-04-06 Upload the Interim Report and Presentation to the wiki; the report should contain the Introduction, including the tasks, team members allocation and Gantt chart, State of the Art, Marketing Plan, Eco-efficiency Measures for Sustainability, Ethical and Deontological Concerns, Proposed Solution and Bibliography chapters
2014-04-10 Interim Presentation, Discussion and Assessment
2014-06-12 Upload the Final Report, Presentation, Video, Paper and Poster
2014-06-19 Final Presentation, Individual Discussion and Assessment
2014-06-26:
Update the wiki with all correction suggestions;
Hand in a CD with the corrected deliverables (source + PDF) together with all code produced to the EPS coordinator;
Hand in one printed exemplar of the report to the EPS coordinator;
Hand in the prototype and user manual to the client.
